The contractor, Miller Contracting, in coordination with Choice One Engineering, executed the project using a phased approach tailored to both site conditions and the operational priorities of the city’s expanding Industrial Park. Construction took place across multiple key corridors, including Progress Drive, Short Road, Hardin Pike Road, Leon Pratt Drive, and through farm fields northeast of Leon Pratt Drive, each requiring a specific installation strategy based on terrain, environmental sensitivity, and system function.

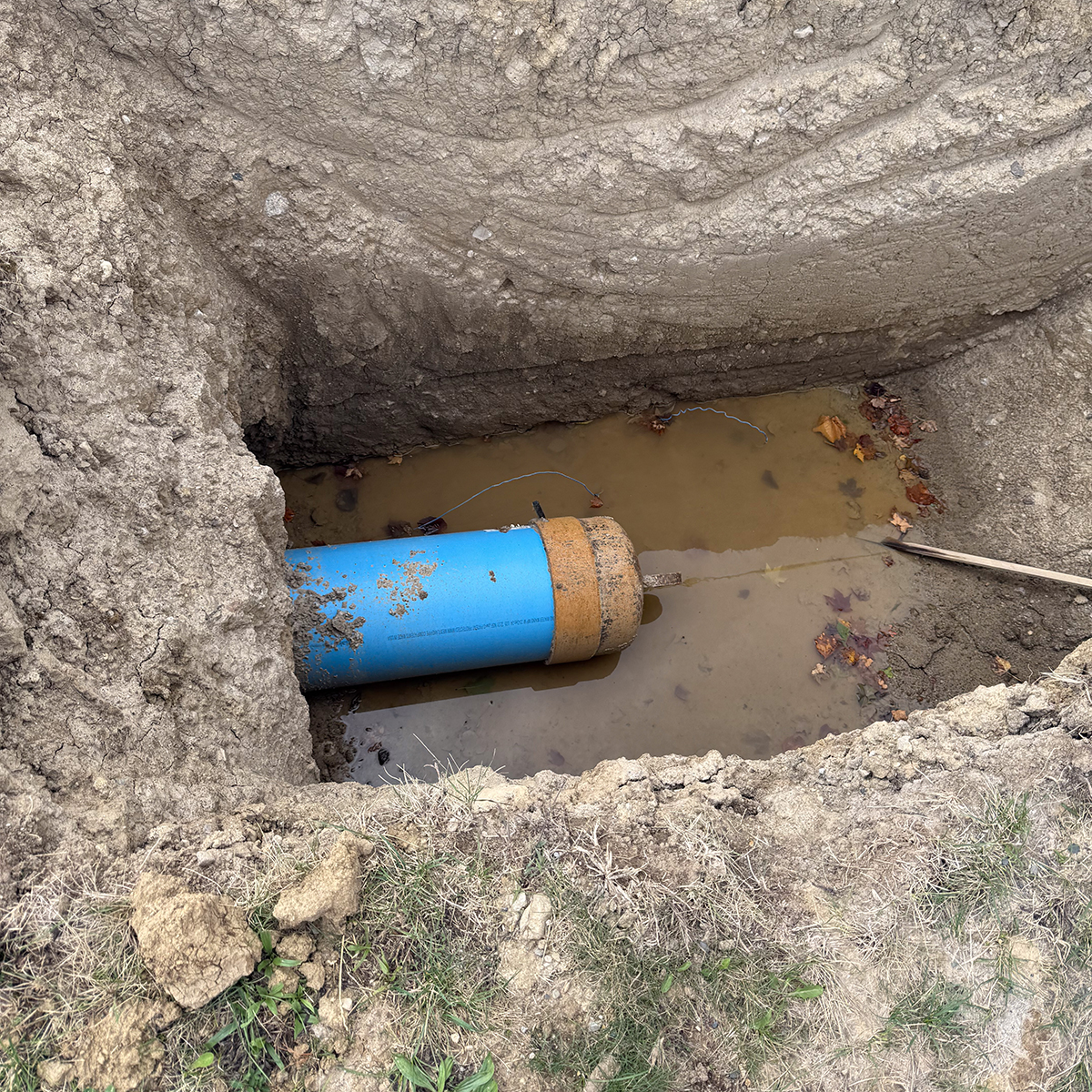

Phase 1 focused on preparation and critical infrastructure components. This included leveling areas where trench depths exceeded 7 feet, as well as installing bends, fittings, and appurtenances in advance of pipe installation. During this phase, HDD was used to complete two critical crossings beneath a waterway within the project vicinity, avoiding environmental disruption.
The HDD installations included:
- Approximately 260 LF of 12-inch C900 DR18 Certa-Lok RJIB
- Approximately 340 LF of 16-inch C900 DR18 Certa-Lok RJIB

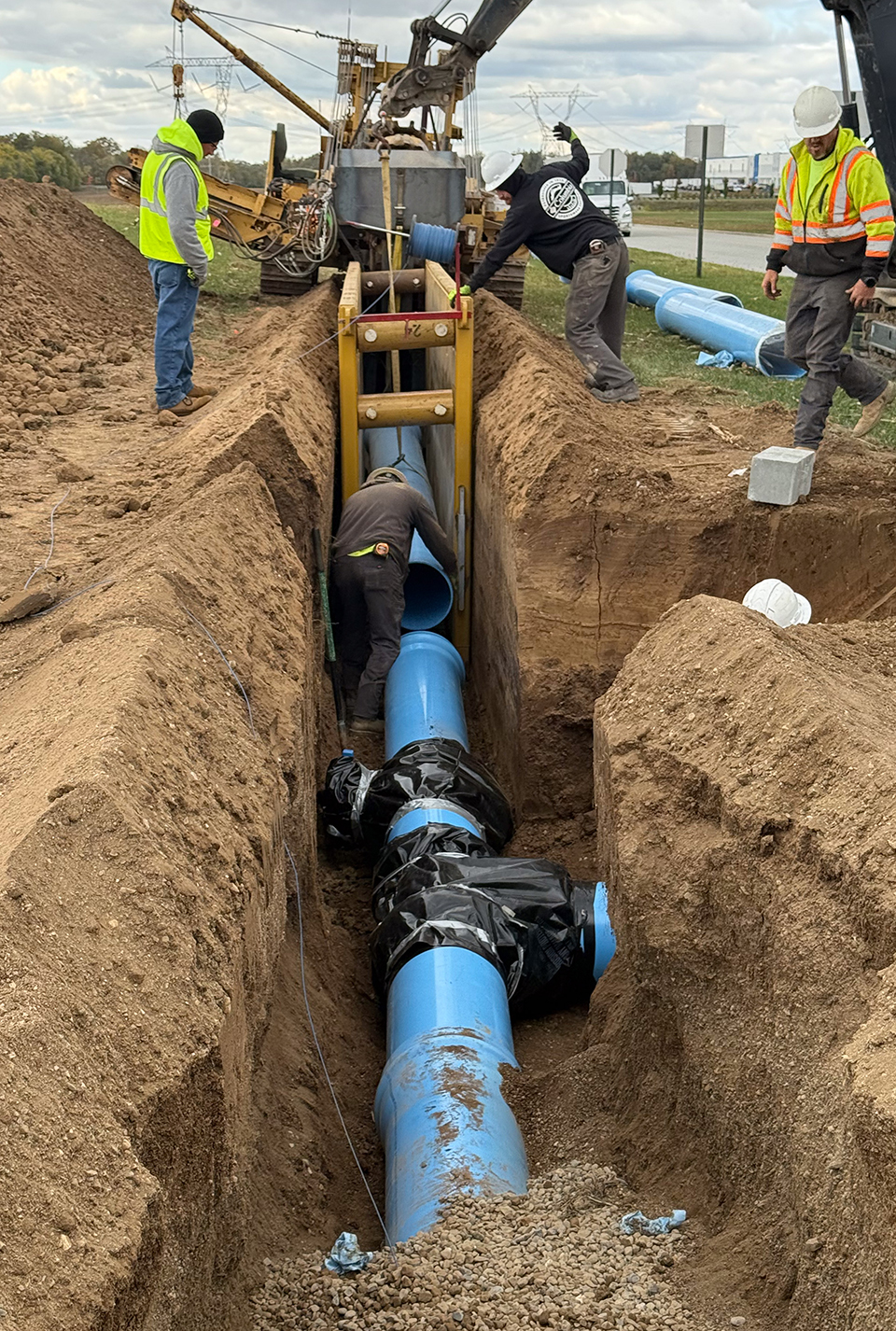

Due to site constraints and surrounding conditions, one of the bores was executed using a half-arc alignment, requiring fittings to transition the pipeline back to the appropriate elevation for tie-in with the rest of the system. This approach allowed the contractor to maintain alignment while adapting to field conditions without compromising performance.

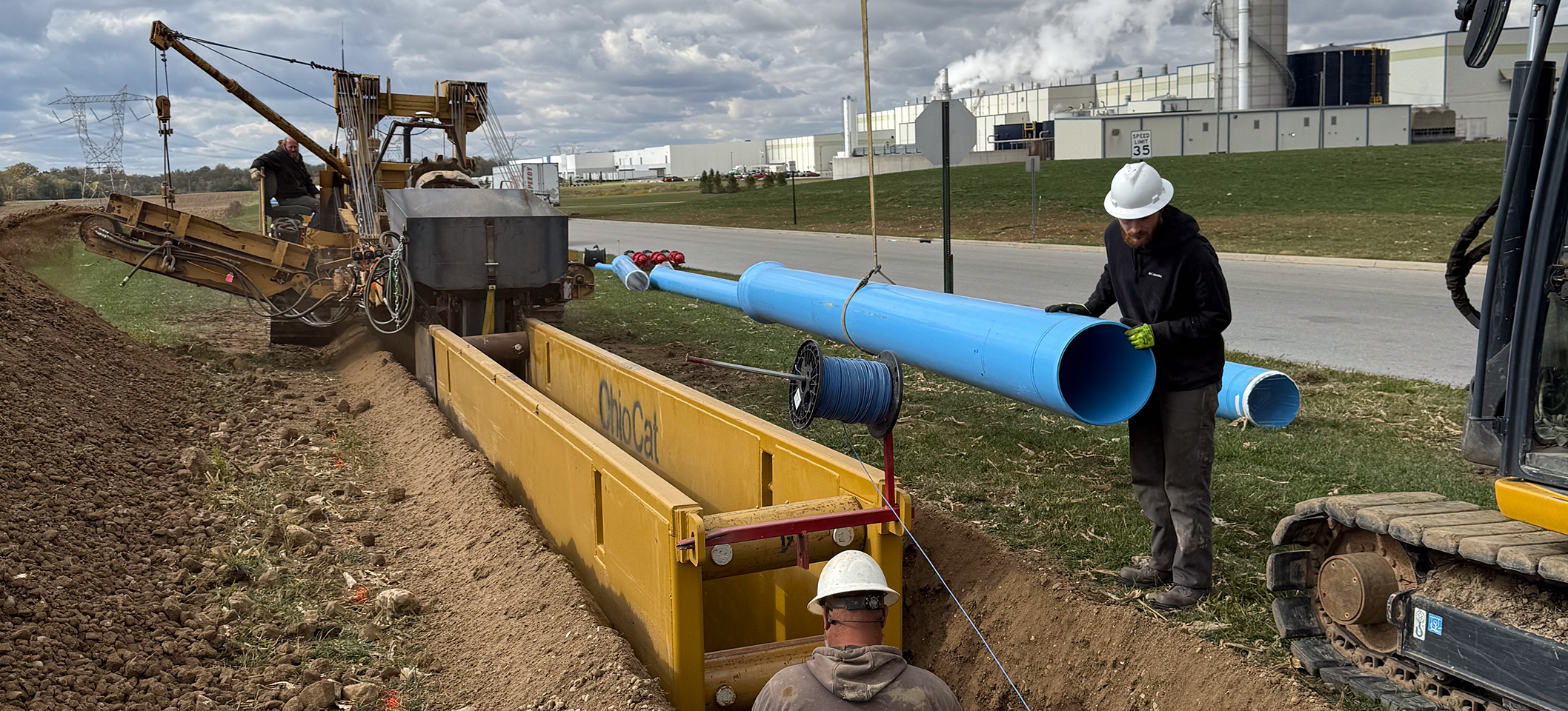

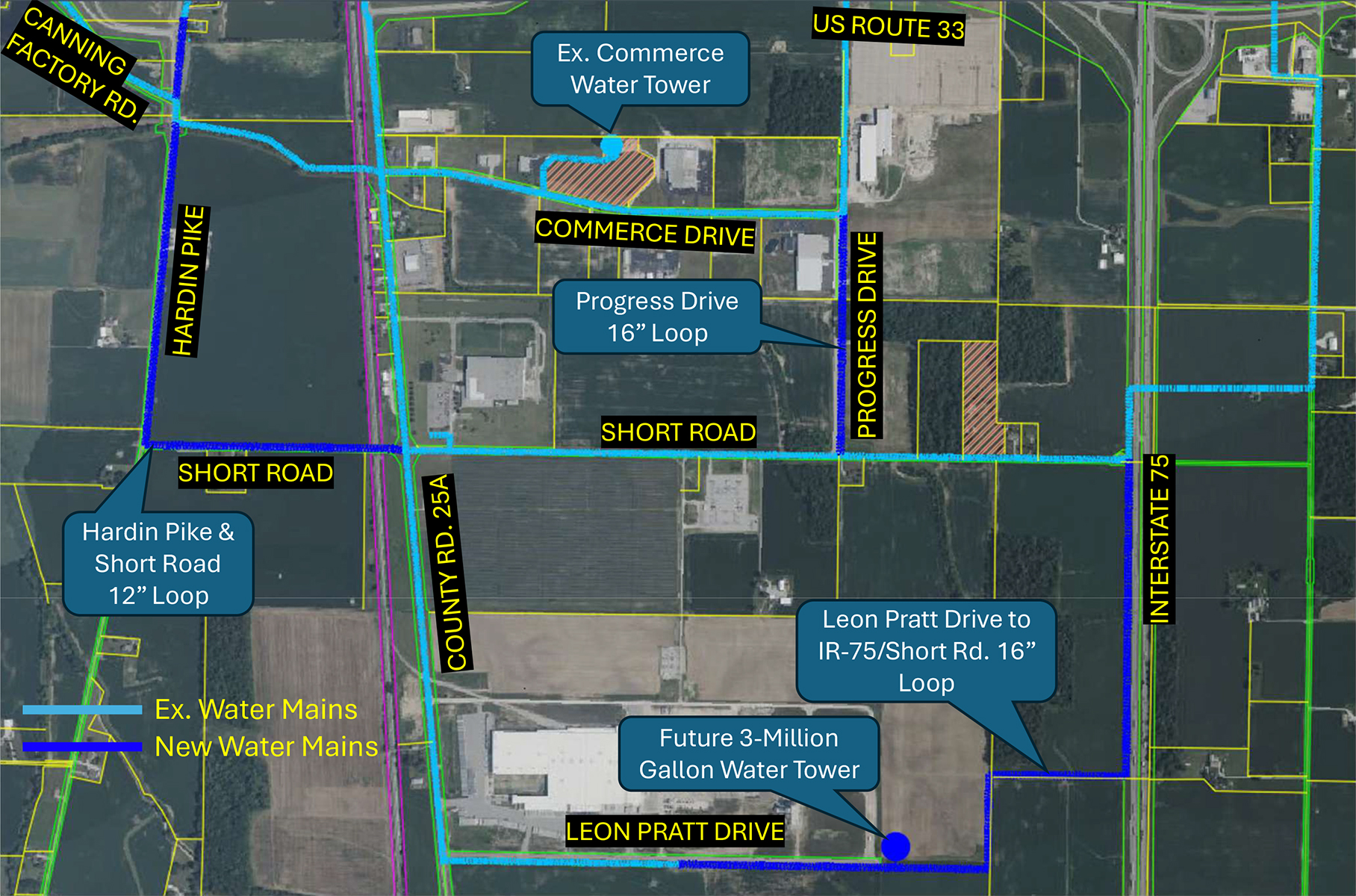

Phase 2 focused on high-efficiency installations of long, straight runs of water main, particularly along open corridors such as Progress Drive and sections connecting the Hardin Pike, Short Road, and Leon Pratt Drive loops. These segments were critical in delivering the system improvements identified in the city’s water study, including:
- Establishing a secondary feed to the Industrial Park and broader system
- Providing redundancy to areas previously served by a single transmission main
- Improving fire flow capacity along Leon Pratt Drive, where limitations previously existed
- Supporting the future 3.0-million-gallon water tower planned near the Pratt Paper facility along Leon Pratt Drive
- Expanding service access to previously undeveloped properties within the Industrial Park

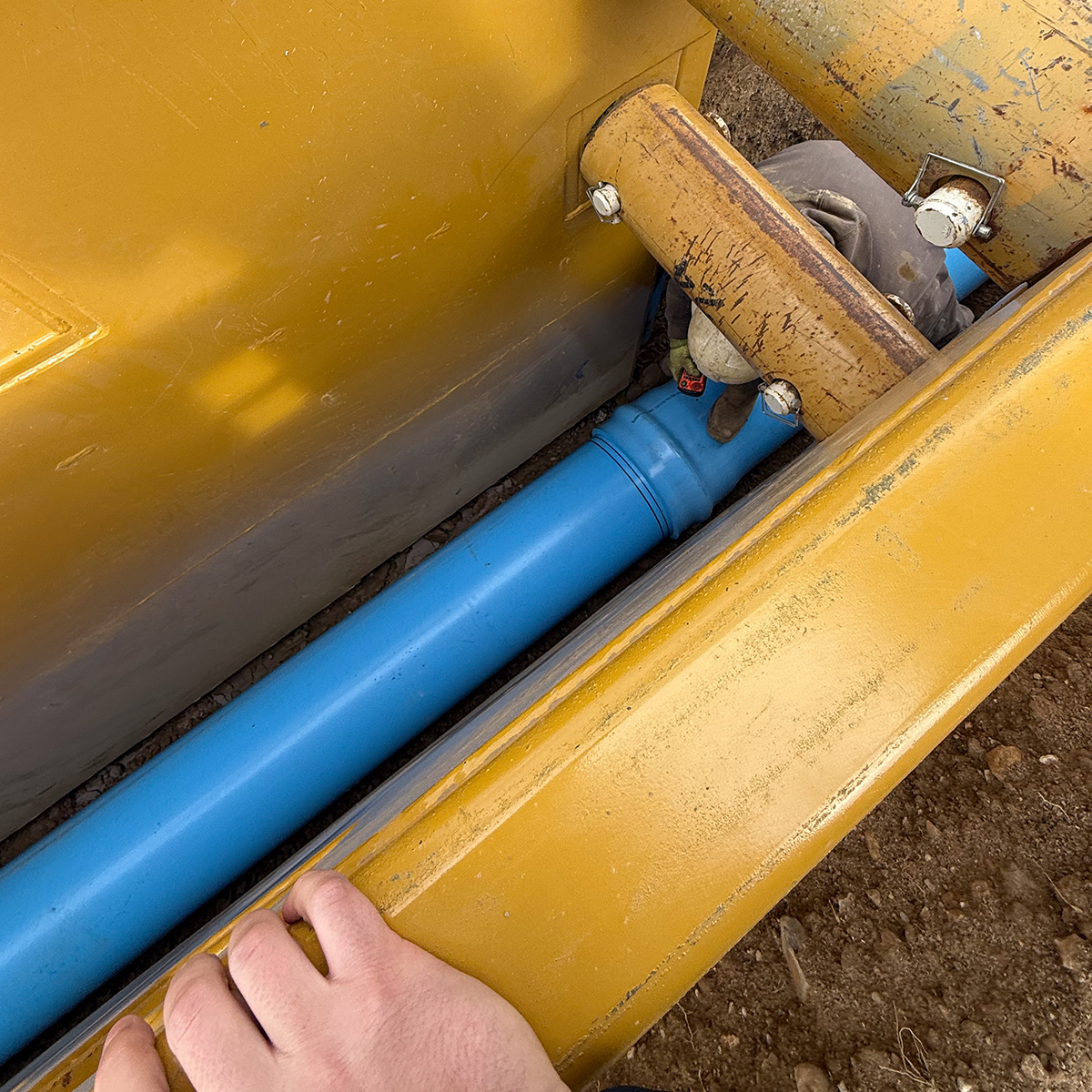

To maximize productivity during this phase, the contractor modified an existing trenching machine to simultaneously cut trench, place bedding, and bell pipe in a single pass. This innovation enabled installation rates of over 1,200 linear feet of 16-inch C909 PVCO pipe per day, significantly accelerating the schedule.
By combining C909 PVCO for long-distance, large-diameter open-cut installation with C900 Certa-Lok restrained joint pipe for trenchless crossings, the project team was able to match installation method to site conditions while maintaining consistent material performance across the system.
The integrated approach minimized environmental impact, reduced installation time, and allowed construction to progress efficiently across varied terrain—ultimately completing the project in approximately three months.
As a result, the City of Wapakoneta now has a more resilient and expandable water distribution system, capable of supporting projected demand growth from 2.4 MGD to 5.0 MGD, while improving system redundancy, fire protection, and long-term service reliability for its Industrial Park and surrounding community.
